Early pay programs are gaining traction in construction as general contractors seek ways to improve their margins and support subcontractors’ cash flow, thereby minimizing project risk. However, the structure of the early pay program can significantly affect whether subcontractors actually participate.
Early pay programs can be priced in several ways, including fixed-rate, time-based, negotiated, and auction-based pricing models. Each approach has different implications for participation, predictability, and overall program performance. Understanding how these pricing structures influence subcontractor behavior is important for designing a program that achieves the desired financial and operational outcomes.
Let’s take a closer look at the auction-based pricing model in construction. In theory, auction pricing allows the market to determine the cost of an early payment.
Table of Contents
How Auction Models Work
In general, in an auction model, subcontractors submit bids indicating the discount they are willing to accept in exchange for early payment.
For example, several subcontractors may request early payment on approved invoices. Each subcontractor submits a bid stating the percentage discount they are willing to offer in exchange for faster payment (often a fixed rate). Most systems inform the user during the bidding process what is needed for their bid to be accepted.
The auction ends, and the program then allocates available capital to the bids offering the highest discounts, since those provide the greatest return to the funding source. The subcontractors then learn whether their requests have been accepted.
While this approach seems simple, allowing the subcontractors determine the pricing dynamically, the model also introduces operational complexity, uncertainty, competition, and questionable optics—all of which limit participation in the program.
How Auction Fixed-Rate Pricing Impacts the Effective Rate
The most common auction model is the fixed-rate early-payment model where a subcontractor’s discount fee is fixed regardless of the payment date. For instance, a 2% fixed rate on a $100,000 invoice costs $2,000.
While the fee is fixed, the rate is not.
The effective annual interest rate fluctuates based on how far in advance the subcontractor receives the funds.
- Initial Scenario: A subcontractor wants to advance a $100,000 payment (at a 2% fixed rate) that would have been paid on March 1 on standard payment timelines. The subcontractor requested the payment be made on January 15, 45 days early. If the payment is 45 days early, the 2% fixed rate on their invoice is equivalent to an annual interest rate of 16% (2% x (360/45)).
- With Processing Delay: If processing takes 5 days (from auction award to the subcontractor’s receipt of money), the payment is made on January 20, 40 days early. The effective rate increases to 18% (2% x (360/40).
- With Manual Check Deposit: If a check payment ($98,000) takes a total of 10 days to deposit, the subcontractor is now paid on January 25, 35 days early, pushing the effective rate up to 21%.
If the subcontractor receives payment 20 days early after the auction is awarded, the 2% fixed rate balloons to a 36% effective annual interest rate.
In this scenario, while the fee is fixed, the effective rate on the advanced payment increases because the fewer the days, the higher the rate.
This variability is critical because if the fixed-rate early payment is awarded but the actual time to payment varies, the equivalent rate can increase significantly, making it more expensive than alternative financing options. Since many alternatives take time into account, you only pay once you have the money, not when the request is processed. As the effective rate increases, subcontractors will naturally evaluate other funding options, affecting program participation and adoption.
In addition to pricing fluctuations, here are a few other ways auction models affect early pay program logistics and outcomes.
The Administrative Burden of Auction Pricing

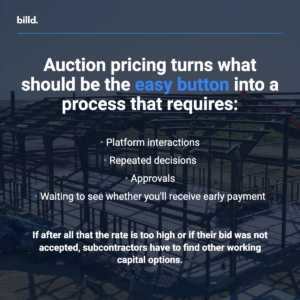

Auction-based pricing introduces administrative complexity for subcontractors because they are required to actively participate in the early payment process on auction days. They must manually log in and submit a bid, specifying the discount they are prepared to accept. Then, they must wait until the auction concludes to learn whether their invoices were accepted. If their bid is ultimately rejected, they must then allocate time to securing alternative financing to cover their cash flow needs.
Because the bidding rate can vary significantly from one early payment request one week to the next, subcontractors may also need approval from management before submitting each bid.
In contrast, most early pay programs with large adoption are less administrative and more straightforward. When they go to request accelerated pay, the subcontractor can log in, see the rate and associated fees, request early payment, and the system tells them when funds will arrive. There is no waiting to see if their bid was accepted or what the price will be this week compared to last week. Often, early pay programs can be set up as a “set and forget” process where the subcontractor can set rules and have the system automatically process the early payment requests. This allows them to automatically receive early payment based on their rules without needing to log in to the portal.

Why Auctions Create Uncertainty Around Pricing & Availability
Auction-based pricing introduces uncertainty in two areas that matter most to subcontractors: price and availability.
From one invoice to the next, subcontractors do not know the cost of early payment when using an auction model. The discount offered depends on the bids submitted by others at that moment. A rate that worked last month may not be competitive on the next invoice.
The program’s availability also becomes uncertain. Even if a subcontractor submits a bid, there is no guarantee they will receive early payment. Capital is limited, and invoices offering the highest discounts typically receive priority. If the market clears at a rate higher than the subcontractor is willing to accept, the subcontractor does not receive funding, forcing them to seek other sources of capital, which may now be time-sensitive.
This uncertainty also makes cash flow forecasting difficult. Subcontractor CFOs rely on predictable sources of working capital to manage payroll, materials, and project expenses. When both the cost and availability of early payment can change from one invoice to the next, the program becomes difficult to rely on as a consistent working capital option.
Imagine needing money from your bank, but instead of offering a predictable loan rate, the bank requires you to bid for capital each time you need it. Businesses compete for a limited pool of funds, and those willing to pay the highest rate receive the money.
Most companies working with that bank would find that process difficult to plan around and frustrating to use.
When both the price and availability of capital are uncertain, many subcontractors choose to find more predictable sources of capital.
How Auction Models Disrupt an Early Pay Program’s Objective Alignment
Auction models aim to maximize yield on individual transactions. However, the primary objectives of most early pay programs in construction are broader, focusing on improving subcontractor cash flow, reducing project risk, and achieving consistent financial outcomes for the general contractor. This focus is critical, given that 83% of subcontractors report working capital concerns (2026 National Subcontractor Market Report).
Subcontractors are strategic partners, not commoditized suppliers, and their financial stability directly impacts project cost, schedule, and the GC’s overall success. Subcontractor liquidity has a demonstrable effect on project performance; for instance, slow payments are linked to a 45% increase in material costs, with an average 11% markup (PYMNTS, 2026’s Digital Blueprint). Therefore, addressing subcontractor cash flow serves not merely as a financing decision but as a proactive strategy to reduce both project cost and risk.
Effective programs rely on predictable and repeatable participation to ensure proven outcomes.
In contrast, auction pricing optimizes for the highest price on a single-transaction basis, often within a constrained pool of capital. This transactional optimization fundamentally conflicts with the broader program goal of consistently reducing risk and improving overall margins. Consequently, the structure of auction pricing may fail to align with the positive outcomes the early pay program is designed to deliver.
Final Perspective
An auction model can generate strong yields for general contractors on individual transactions, but introduces subcontractor complexity and uncertainty, which limits participation and makes subcontractor adoption an even bigger challenge for general contractors to overcome.
Auction models tend to work in environments with non-strategic suppliers and constrained capital, often found in large buying organizations that offer early payment programs to their long-tail suppliers. Construction is different. Subcontractors are core partners, and their financial stability directly impacts project cost and risk.
This comes down to a simple question: What problem is the program solving?
If the goal is to maximize yield with a limited pool of cash, an auction-based program can achieve it. If the goal is to improve subcontractor cash flow, reduce risk, and generate consistent outcomes for you and your subcontractors, then auctioning is not an effective model.
The opportunity is not to make access to capital more complex and uncertain, which can limit adoption, but to deliver a predictable solution that drives participation, generates GC margins, supports subcontractors, and improves project outcomes. Three-quarters of subcontractors are willing to offer discounts in exchange for faster payment (PYMNTS). Given this clear interest in early pay programs, why complicate it?
